Home > Guide to Factory Installation Procedures > City Planning Act Profiles > Flow of Procedures

Guide to Factory Installation Procedures
Followings are applicable when procedures based on laws or ordinances, etc. are required.

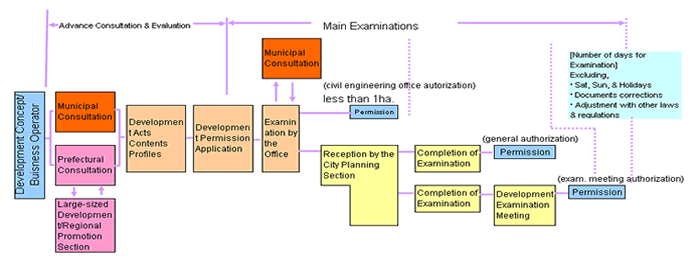

Flow of Procedures−City Planning Act
Number of Processing Days −City Planning Section−
Name of Permits and Licences Number of Processing Days
Total Days Office Head Office
Development Permission (Act Article 29) 40 20 20
Large Development Permission (Act Article 29) 55 25 30
Change Permission (Act Article 35-2 (1)) 35 20 15
Building Restriction Cancellation (Act Article 37) 15 5 10
Building Coverage Ratio, etc. Special Permission (Act Article 41 (2))) 35 20 15
Building Permission for Structures other than Scheduled Buildings(Act Article 42 (1)) 35 20 15
Building Permission (Act Article 43 (1)) 35 20 15
Approval for the Succession of Status (Act Article 45 ) 15 5 10
Application for Issuance of Development Registration Copy (Act Article 47 (5)) 5 5
Number of Processing Days −Civil Engineering Office−
Name of Permits and Licences Number of Processing Days
Total Days Office Head Office
Development Permission (Act Article 29) 25 25
Change Permission (Act Article 35-2 (1)) 20 20
Building Restriction Cancellation (Act Article 37) 10 10
Building Coverage Ratio, etc. Special Permission (Act Article 41 (2)) 20 20
Building Permission for Structures other than Scheduled Buildings(Act Article 42 (1)) 20 20
Building Permission (Act Article 43 (1)) 20 20
Approval for the Succession of Status (Act Article 45 ) 10 10
Issuance of Certificate for Concerning Development or Construction Activities (Rule Article 60) 10 10
